Rehabilitation of the Dutch Point Viaduct
State Project No. 0063-0726
Construction Update
14-Day Lookahead for the weeks of November 17 and November 24
As the schedule is subject to change, please check our website for the most current updates.
TRAFFIC IMPACTS:
LONG-TERM LANE CLOSURE/DETOUR REMAINS IN EFFECT:
The long-term closure of one of the three lanes of I-91 SB through the work zone will remain for the duration of the project. The project is being constructed in three stages. Stage 1 construction began on March 11, 2025. Stage 3 construction is scheduled to be completed in September 2026.
The State Street on-ramp to I-91 SB located at the Founders Bridge will remain CLOSED for the duration of the project to facilitate the temporary traffic patterns on I-91 SB throughout staged construction. Detours are posted to direct motorists seeking I-91 SB to use either the South Morgan Street on-ramp to I-91 SB at Columbus Boulevard or the Sheldon Street on-ramp to the Whitehead Highway at Columbus Boulevard, where they can access I-91 SB.
The Stage 1 traffic pattern includes a work zone and reduced travel way width on the Whitehead Highway on-ramp to I-91 SB.
Motorists on I-84 EB seeking I-91 SB will be required to merge with I-91 SB traffic due to the temporary traffic patterns on I-91 SB during staged construction. I-84 EB motorists entering I-91 SB traffic previously had a dedicated lane provided.
Temporary nighttime lane closures are expected on I-91 SB during the project from 8:00 pm to 6:00 am.
Temporary daytime shoulder closures are expected on I-91 SB during the project from 9:00 am to 3:00 pm.

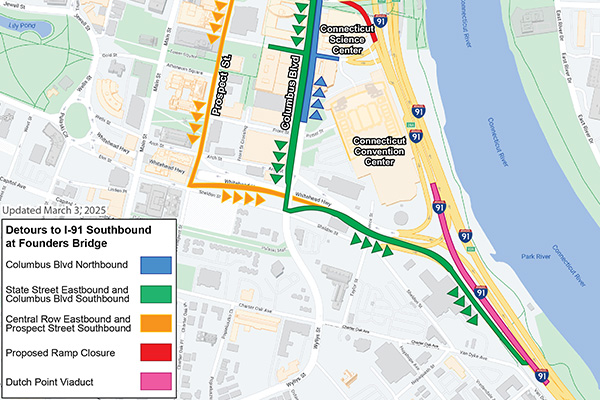

State Street on-ramp to I-91 Southbound Detour Graphic
Wednesday, November 12, and Monday, November 17, motorists should expect the following traffic impacts and closures:
• I-91 NB off-ramp to the Whitehead Highway (Exit 29A)
o Left lane closure from 9:00 AM to 2:30 PM
November 17 through November 21:
- Lead abatement (day)
- Prep and prime for steel repairs (day)
- Remove and install shielding (day)
- Install hangers and overhang brackets (day)
- Bridge edge formwork on I-91 SB (day)
- Falsework (day)
- Install stay-in-place deck and foam on I-91 SB (day)
- Install rebar on I-91 SB (day)
- Surveying on I-91 SB (day)
- Steel strengthening, repairs and inspections (day)
November 24 through November 26:
- Lead abatement (day)
- Prep and prime for steel repairs (day)
- Remove and install shielding (day)
- Install hangers and overhang brackets (day)
- Bridge edge formwork on I-91 SB (day)
- Falsework (day)
- Install stay-in-place deck and foam on I-91 SB (day)
- Install rebar on I-91 SB (day)
- Surveying on I-91 SB (day)
- Steel strengthening, repairs and inspections (day)
